close
Skip to content

Competencies covered

MSFFL2006: Prepare, select and apply smoothing and patching compounds

MSFFL2007: Select and apply appropriate compounds and additives

MSFFL2009: Select, prepare and apply moisture barriers and damp proof membranes to concrete sub-floors

Estimating quantities

Image for slide 1
Audio for slide 1 (mp3 |6|KB)

We looked at the basic principles of estimating primer and underlayment quantities in the unit: Planning and costing.

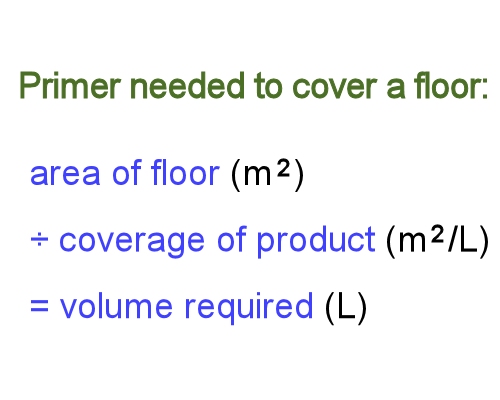

You'll recall that the simple formula for working out the amount of primer needed to cover a floor is:

        Area of floor ÷ coverage of product = volume required

The units of measure that these figures are generally expressed in are:

  • Area of floor - square metres (m2)

  • Coverage of product - square metres per litre (m2/L)

  • Volume required - litres (L)
hearing icon
Image for slide 2
Audio for slide 2 (mp3 |6|KB)

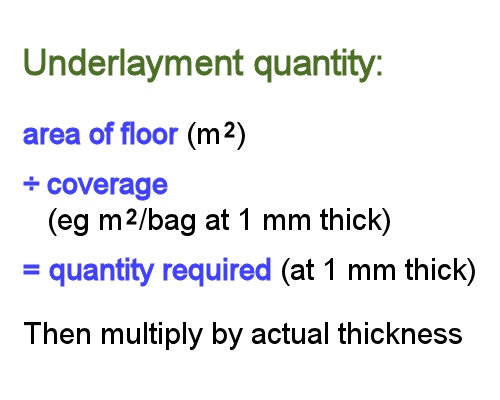

The same principle is used for working out underlayment quantities.

However, this time the coverage is generally shown in square metres per bag or kilogram at a given thickness (m2/bag or m2/kg at whatever thickness the manufacturer nominates).

This means that if your finished thickness is going to be different from the manufacturer's nominated thickness, you'll need to make an adjustment to the quantity.

hearing icon
Image for slide 3
Audio for slide 3 (mp3 |6|KB)

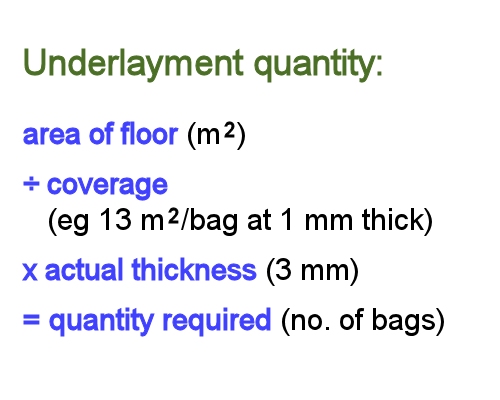

For example, say you were going to spread a levelling compound at an average thickness of 3 mm on the subfloor, and the coverage rate printed on the bag reads:

        Coverage: 13 m2/bag at 1 mm thick

To work out the total quantity of compound required, you would need to use the same formula and multiply your answer by 3.

hearing icon
Image for slide 4
Audio for slide 4 (mp3 |6|KB)

If you need to revise these basic principles before we move on to some more complex examples, go to the following lessons in Planning and costing:

You may also want to revise the maths basics that underlie these calculations in the unit: Making measurements.

hearing icon
Image for slide 5
Audio for slide 5 (mp3 |6|KB)

Ramps

In geometric terms, ramps are actually triangular prisms. That is, they are a normal square or rectangular shape on top, but their depth is triangular.

Let's say you needed to build a ramp between two rooms to accommodate a floor height difference of 20 mm. You have chosen a slump-free repair mortar with a coverage rate that reads:

        Coverage: 12 m2 at 1 mm thick (per 20 kg bag)

The steps involved in working out the quantity are as follows. Remember that we have to convert all measurements from millimetres to metres for these calculations.

hearing icon
Image for slide 6
Audio for slide 6 (mp3 |6|KB)

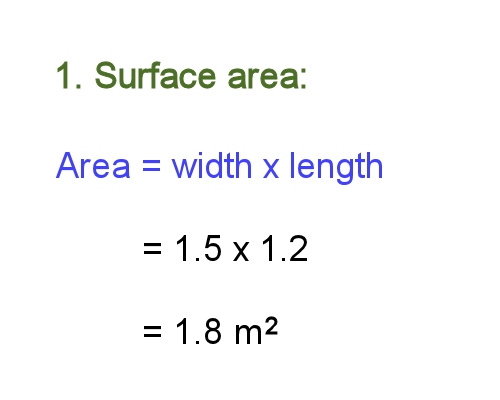

1. Find the surface area

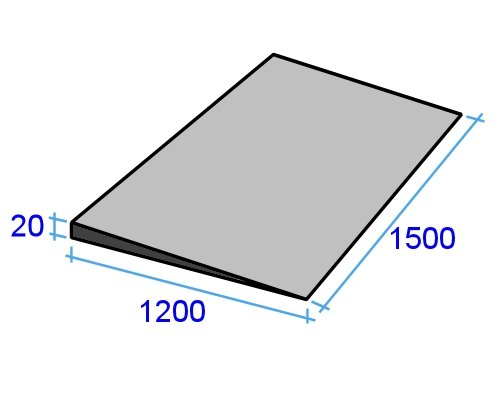

Area = width x length = 1.5 x 1.2 = 1.8 m2

hearing icon
Image for slide 7
Audio for slide 7 (mp3 |6|KB)

2. Find the coverage for the given thickness

The nominated coverage is 12 m2 per 20 kg bag when spread at an average thickness of 1 mm. So if the ramp was only 1 mm thick, you would need:

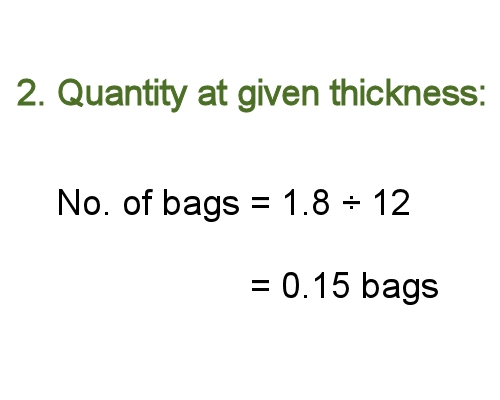

        1.8 m2 ÷ 12 = 0.15 bags

hearing icon
Image for slide 8
Audio for slide 8 (mp3 |6|KB)

3. Find the total number of bags

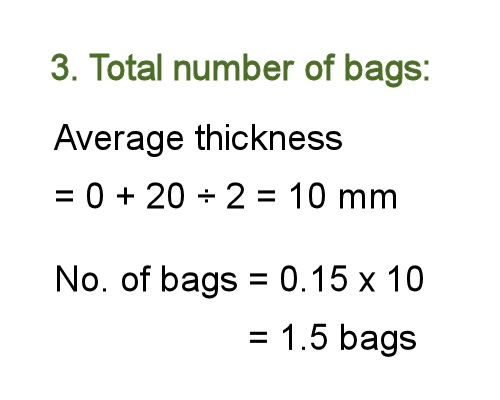

In our case, the ramp thickness goes from 0 mm at one end to 20 mm at the other. So the average thickness is 10 mm. In other words:

Average thickness = thickness at start + thickness at end ÷ 2

        = 0 + 20 ÷ 2 = 10 mm

This means we need to multiply the Step 2 figure by 10:

        0.15 x 10 = 1.5 bags

hearing icon
Image for slide 9
Audio for slide 9 (mp3 |6|KB)

Diluted primer

Some primers are diluted with water when the substrate surface is very porous.

Let's say that you have diamond ground the concrete subfloor shown in this diagram and are about to coat it with primer.

hearing icon
Image for slide 10
Audio for slide 10 (mp3 |6|KB)

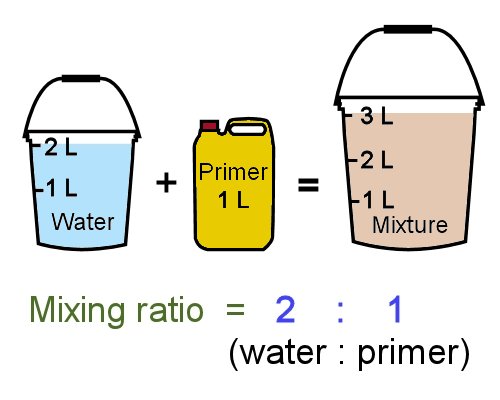

The container says that the coverage rate is 3.5 m2/L, but that for porous concrete the primer should be diluted with water at a 2:1 ratio.

This means that 2 parts water will be added to every 1 part primer. In other words, if there was a total of 3 litres required for the floor, 2 litres would be water and 1 litre would be primer.

How much water and primer will you need for this job?

hearing icon
Image for slide 11
Audio for slide 11 (mp3 |6|KB)

Step 1: Find the area

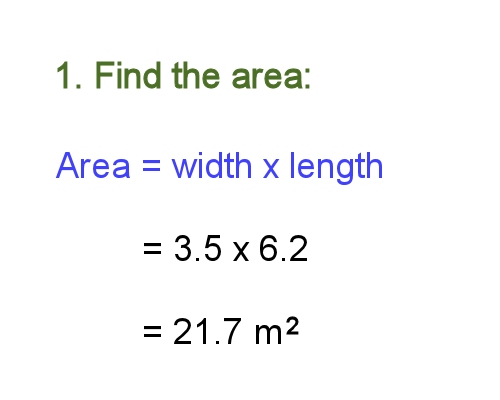

        Area = 3.5 x 6.2 = 21.7 m2

hearing icon
Image for slide 12
Audio for slide 12 (mp3 |6|KB)

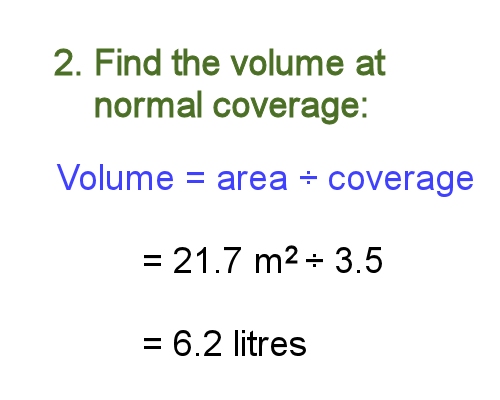

Step 2: Find the total volume at the normal coverage rate

Volume (L) = area (m2) ÷ coverage (m2/L)

        = 21.7 m2 ÷ 3.5 = 6.2 litres

hearing icon
Image for slide 13
Audio for slide 13 (mp3 |6|KB)

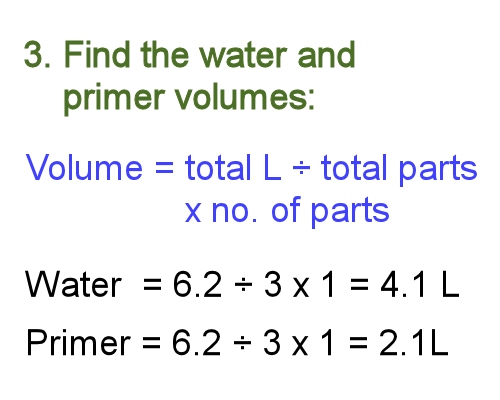

Step 3: Find the water and primer volumes

A water/primer ratio of 2:1 means: 2 parts water + 1 part primer = 3 parts in total. So:

Volume of water = total volume ÷ total no. of parts x no. of parts water
= 6.2 litres ÷ 3 parts (in total) x 2 parts (water)
= 4.1 litres
Volume of primer      = 6.2 litres ÷ 3 parts (in total) x 1 part (primer)
= 2.1 litres

You can check your answer by adding the two components together:

        4.1 litres water + 2.1 litres primer = 6.2 litres in total

hearing icon
Image for slide 14
Audio for slide 14 (mp3 |6|KB)

Wastage factors

Depending on the type of job and the products you're using, you may want to build a wastage factor into your calculations. This helps to compensate for slight variations in estimates or small amounts of wastage.

Installers often allow for 5 to 10% wastage on primers and levelling compounds. For example, if you wanted to add 10% wastage to the primer calculation above, the total volume required would be:

        6.2 litres + 10% (0.62 litres) = 6.8 litres

If you need more practise on using percentages, go to the 'Decimals and percentages' lesson in Making measurements.

hearing icon

Learning activity

Audio 15 (mp3 |6|KB)

You need to install a ramp between two floor levels, as shown in the drawing below. The slump-free repair mortar compound has a coverage rate of 14 m2 at 1 mm thick per 20 kg bag.

You will then apply a primer to the finished ramp.

The primer coverage rate is 5 m2/L. However, you will dilute the primer with water at a 1:1 ratio.

How much repair mortar and primer will you need for this job? Add a 10% wastage factor to each amount.

hearing icon

  Go to  Assignment
